FencingWise

Security Fencing Procurement: Release a Complete Factory Order

A security fencing procurement checklist should end with a package the factory can quote, manufacture and inspect against one revision. We recommend connecting the section drawings, component quantities, evidence and accepted departures before production approval. This makes custom widths, special posts, gates and delivery stages visible instead of leaving critical decisions scattered across emails.

Build the checklist around four records

Use a section drawing, a component schedule, an evidence register and a deviation list. Give them matching project and revision references. This is usually easier to maintain than repeating every technical detail in emails, quotation notes and separate spreadsheets.

The section drawing defines where the fence goes and how it connects. The component schedule counts what will be supplied. The evidence register addresses specified performance and inspection requirements. The deviation list records differences from the enquiry and their acceptance status.

A revision in any one of these may affect the others. A taller panel can change posts and foundations; a new gate position changes terminal connections and quantities; a coating substitution changes inspection and repair information.

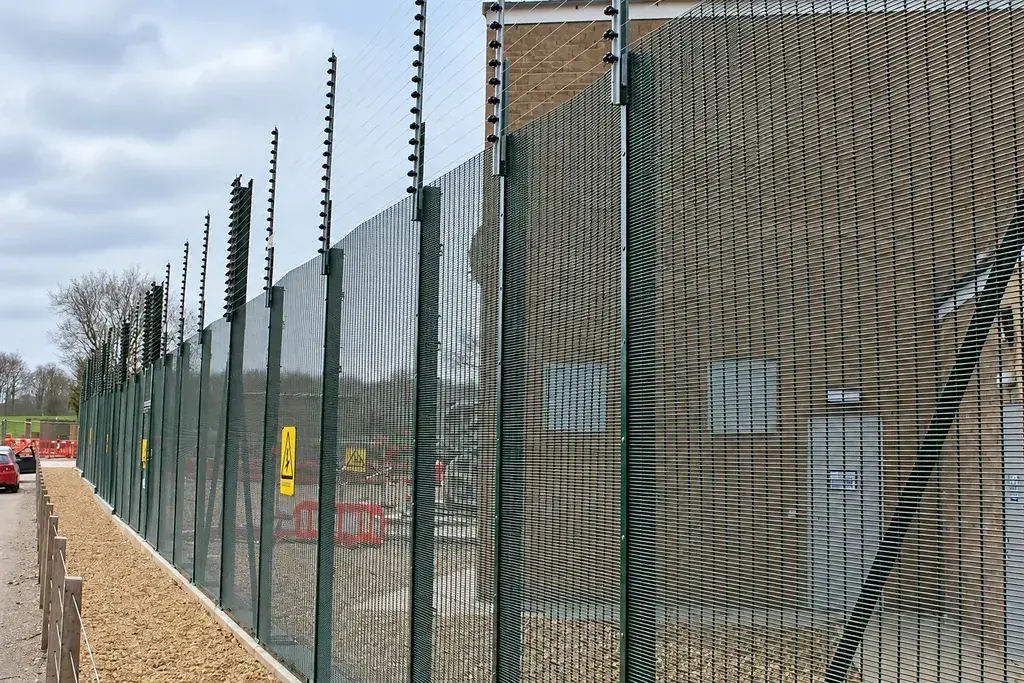

Security mesh fence run with posts and upper fence components
A complete material schedule identifies panels, posts, upper components and their approved interfaces.

Set the acceptance fields before collecting prices

Record Required content Release condition
Fence sections System reference, height, ground detail and surveyed extent Designer-approved arrangement identified
Panels Construction, finished dimensions and special widths Quantity and dimensional basis agreed
Posts Intermediate, terminal, corner and gate references Each position assigned to a defined component
Connections Clamp or bar detail, fasteners and quantities Complete assembly identified, not loose-bolt shorthand
Gates Clear opening, movement, supports and hardware Gate drawing and interfaces accepted
Finish Substrate, coating route, colour and repair requirements Component coverage and inspection basis agreed
Evidence Required report or certificate and applicable scope No unresolved mandatory evidence gap
Delivery Phase, labels, packing and destination Receiving arrangements match the material groups

A buyer can use these fields without assuming that every project needs the same security level. The project's requirements determine the acceptance criteria; the checklist makes their implementation traceable.

Complete a quantity example

Assume an illustrative open-ended run with 48 bays on an approved 2.5 m pitch and no gates or corners. The distance between the first and last post centres is 48 × 2.5 = 120 m. There are 49 post positions: 47 intermediate and 2 terminal.

If each panel edge requires four complete fixing sets, the run needs 48 × 2 × 4 = 384 sets. Suppose the project separately decides to buy 16 additional sets for future maintenance. Show 384 installation sets and 16 spares as separate lines, totalling 400; do not conceal the spare decision by inflating the installed quantity.

This is a counting example, not a universal fixing specification. Use the approved system detail for the number and type of connections. Post caps, base fixings and special brackets must be counted under their own rules rather than assumed included in a panel-edge set.

Assign unresolved items to an owner

Assign each open item to the party able to supply the missing answer, and state which component or production step depends on it. A supplier can price a known fixing; a surveyor or designer may need to establish its position first. Keep mandatory evidence gaps separate from commercial negotiation so progress on price cannot be mistaken for approval of an unresolved system configuration.

Use simple statuses such as open, answered for review and accepted. “Noted” is ambiguous: it may mean someone has seen a problem without deciding what to do. Record who accepted a deviation and which drawing or schedule incorporates it.

If a mandatory security certificate does not cover the proposed configuration, keep that item open regardless of progress on dimensions or price. See the certified-system scope review for the evidence method.

Review packing as part of completeness

Group components by installation sequence where that helps the project. Label special panels and gate-adjacent parts by their drawing references. A correct overall count can still cause delays when a small component needed in phase one is packed with the final delivery.

Agree the receiving check: package identification, quantities, visible condition and documents. Identify how damage or shortages should be recorded before parts are dispersed around the site. This creates a clean link between the ordered schedule and the goods actually received.

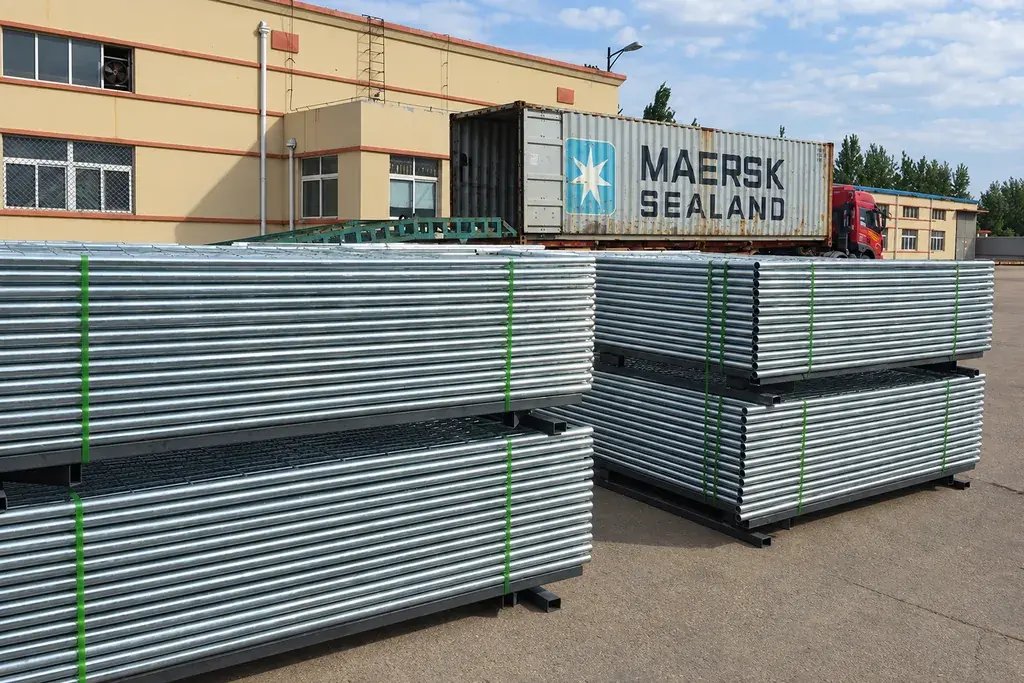

Bundled metal fence components staged near a shipping container
Bundled components still need package identification, quantities and visible-condition checks against the accepted schedule.

Release one controlled package

Before release, reconcile the final quotation with approved drawings, component counts, finish samples and required inspection records. Identify excluded options and superseded files explicitly. The factory should receive one definite scope, while the buyer retains the decision trail explaining any custom detail or accepted alternative that differs from the original enquiry.

The project supply process can then carry those references through manufacture and shipping. The checklist has done its job when another person can reconstruct the decision from the issued records without relying on an undocumented conversation.
