FencingWise

Compare Security Fence Quotations by Complete Order Scope

To compare custom security fence quotations, give every supplier the same drawing revision, component quantities and evidence requirements. We recommend reviewing technical differences before price: special widths, gate posts, clamps and packing can change the supplied package substantially. The worked example below shows how to compare a complete order rather than an attractive panel unit price.

Freeze the technical comparison first

Issue one enquiry schedule showing standard bays, custom bays, transitions and gates. For each line, request the proposed construction, finish, supplied fittings and any departures from the specified system. This gives our quotation discussion a definite scope and allows the buyer to separate an economical manufacturing alternative from an omission that will need another purchase.

Use three statuses for each requirement: included as specified, identified alternative, or unresolved. Do not translate an unanswered item into zero cost. If certification is required, verify the proposed assembly before comparing commercial totals; a low price cannot compensate for missing mandatory evidence.

The security procurement checklist provides the technical release fields. This article concentrates on turning accepted quantities and scope into a comparison that can be audited.

Count the actual assemblies

For illustration, take one straight open-ended run containing 80 equal bays and no gates. A simple arrangement has 81 post positions: 79 intermediate positions and 2 terminal positions. This count assumes one post at every bay junction and each end; the actual system may introduce additional supports or different terminal details.

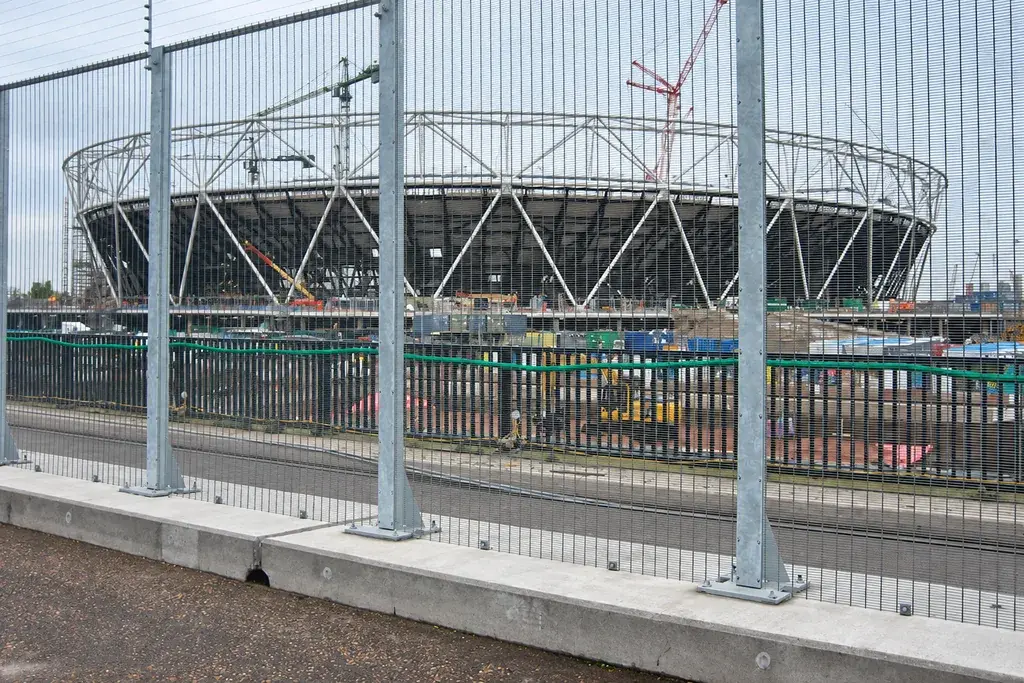

Installed security mesh fence panels and posts beside a stadium
A fence price needs the panel, post and connection quantities for the actual run.

If the approved fixing arrangement uses four panel fixing sets at each panel edge, 80 panels have 160 edges and require 640 sets. Do not count only four sets per post: an intermediate post receives two panel edges in this example. Define what one set contains before comparing a bag of bolts with a complete clamp assembly.

Corners, gates and transitions should be separate lines. If an opening splits a fence into two runs, use each run's endpoints rather than treating the combined length as a single uninterrupted sequence.

Put both offers into one cost table

The following figures are invented currency units for an arithmetic example. They are not FencingWise prices, market rates or a quotation. Assume the two offers have already been shown technically equivalent and cover the same delivery basis.

Required item Quantity Offer A unit cost A total Offer B unit cost B total
Panels 80 42 3,360 45 3,600
Intermediate posts 79 28 2,212 27 2,133
Terminal posts 2 40 80 38 76
Fixing sets 640 1.20 768 1.00 640
Packing and delivery 1 800 800 650 650
Total — — 7,220 — 7,099

Offer A has the lower panel price but costs 121 more for this defined package. A comparison using panels alone would reach the opposite conclusion. The percentage difference against Offer B is 121 ÷ 7,099 × 100, approximately 1.70%.

Do not add taxes, duties or installation to one column only. Where those items differ by trade term or destination, establish a common landed or delivered scope with the appropriate logistics advice before deciding.

Separate omissions from genuine options

Optional colour, additional spares and a different gate arrangement should remain visible alternatives. A required cap or fixing cannot be treated as optional simply because a supplier left it off the first quotation.

For each difference, record the owner and resolution: supplier to price, designer to approve, buyer to provide information or another contractor to supply. This creates a useful clarification list and prevents the same missing item from being counted by two parties.

Transport descriptions also need precision. Identify destination, unloading responsibility, packing type and any split-delivery requirement. An included shipment to a port is not automatically delivery to a construction compound.

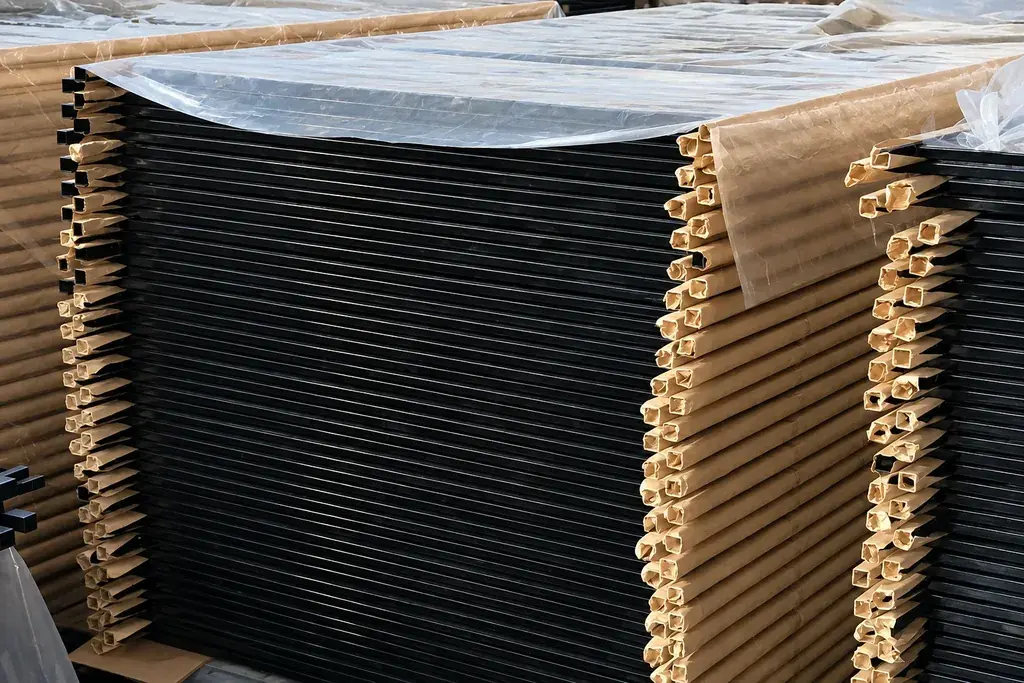

Stacked metal security fence panels protected for shipping
Packing and delivery belong in the compared scope alongside the fence components.

Check commercial conditions without inventing certainty

Ask suppliers to state what triggers their proposed production schedule, such as drawing approval, sample acceptance or agreed payment conditions. Keep inspection, packing, split shipments and delivery responsibility visible beside the price. These conditions should be compared as written commitments for the actual order; they cannot be inferred from a catalogue lead time or a quotation issued before the design was settled.

Retain the quoted revision after negotiation. If one supplier changes the panel or coating to reduce cost, reopen the technical comparison before accepting the new total. A spreadsheet cannot detect a product substitution unless the specification is attached to the line item.

The final comparison should leave the buyer with an accepted scope, identified exceptions and a traceable price basis. Use the project supply process to carry those references into the order and packing list.
